The IT trade exists in a prolonged state of staffing shortages. Sources are strained, points in time are tight, and haphazard answers like “crunch time” may have a devastating impact on staff participants. In the meantime, kind of 12% of the cash invested in tasks is robotically misplaced to deficient making plans. How can venture managers stem this loss in an trade the place time and exertions are already stretched to the restrict?

With 86% of tool groups adopting Agile practices as of 2021, it’ll look like Agile answers are the best choice. However Agile is not anything if now not versatile: Making use of vital chain venture control (CCPM) making plans to an Agile workflow is an effective way to spot and unravel chokepoints in processes whilst nonetheless maintaining some great benefits of Agile supply. The use case in this article is going to display you find out how to make the most of a hybrid CCPM/Agile method.

The Crucial Chain Way in Challenge Control

CCPM is among the most efficient venture control gear for optimizing sources. It was once first described in Eliyahu M. Goldratt’s 1997 e book Crucial Chain, and builds on his previous idea of constraints. Briefly, CCPM supplies a framework to spot and restrict venture constraints. You’ve most probably heard the pronouncing {that a} chain is handiest as robust as its weakest hyperlink—CCPM seeks to pay attention efforts at the vulnerable hyperlinks that threaten the entire venture.

CCPM handles those vulnerable hyperlinks with six steps that, taken in combination, support the potency of to be had sources whilst ensuring they’re assigned the place they’re maximum wanted:

  • Determine the vital chain. In any venture, there are a sequence of duties that completely should be finished for the venture to achieve success. When figuring out the vital chain, the venture supervisor defines probably the most vital and time-consuming duties, in addition to feeder chains, on which the vital chain depends. For example, “write documentation” could be a role at the vital chain, whilst “make a choice documentation tool” could be a role at the feeder chain.
  • Determine conceivable useful resource constraints. Believe barriers it’s possible you’ll face when assigning staff to assignments (e.g., holidays or different deliberate leaves).
  • Building up focal point through getting rid of multitasking. Holding staff participants serious about explicit actions will result in upper productiveness. Multitasking is recognized to obstruct efficiency, and getting rid of it’s going to can help you assign much less time according to assignment.
  • Estimate time through assuming single-task assignments. CCPM operates below the idea that if a staff member is that specialize in a unmarried assignment, the time allocated to that assignment will also be reduce in part. For example, in case your preliminary estimation for a given assignment is 4 days, after getting rid of multitasking, that point will also be reduce down to 2 days.
  • Upload buffers. Reintroduce a part of the diminished time as a buffer for the vital duties. The usage of the similar estimation instance famous above, for those who cut back a four-day assignment to 2 days, upload yet one more day to the plan in case the duty takes longer than anticipated.
  • Rewrite your plan. The usage of your new time frames and buffers, write a brand new venture plan. At this degree, you will have to degree sources, reallocating time, exertions, and gear as vital.

The objective of this procedure is so as to add buffers round occasions and interdependencies which can be essential to venture results. CCPM makes use of 3 sorts of buffers to make sure well timed supply:

  • Challenge buffer: The pooled time discovered after the ultimate assignment and earlier than venture of entirety. That is the contingency that the majority vital chain actions have.
  • Feeding buffer: The time added to duties at the feeder chain that guarantees that delays on the ones duties is not going to impact probably the most essential actions.
  • Useful resource buffer: The reserve of bodily sources (i.e., staff or apparatus) that may be reallocated as wanted if the venture requires it.

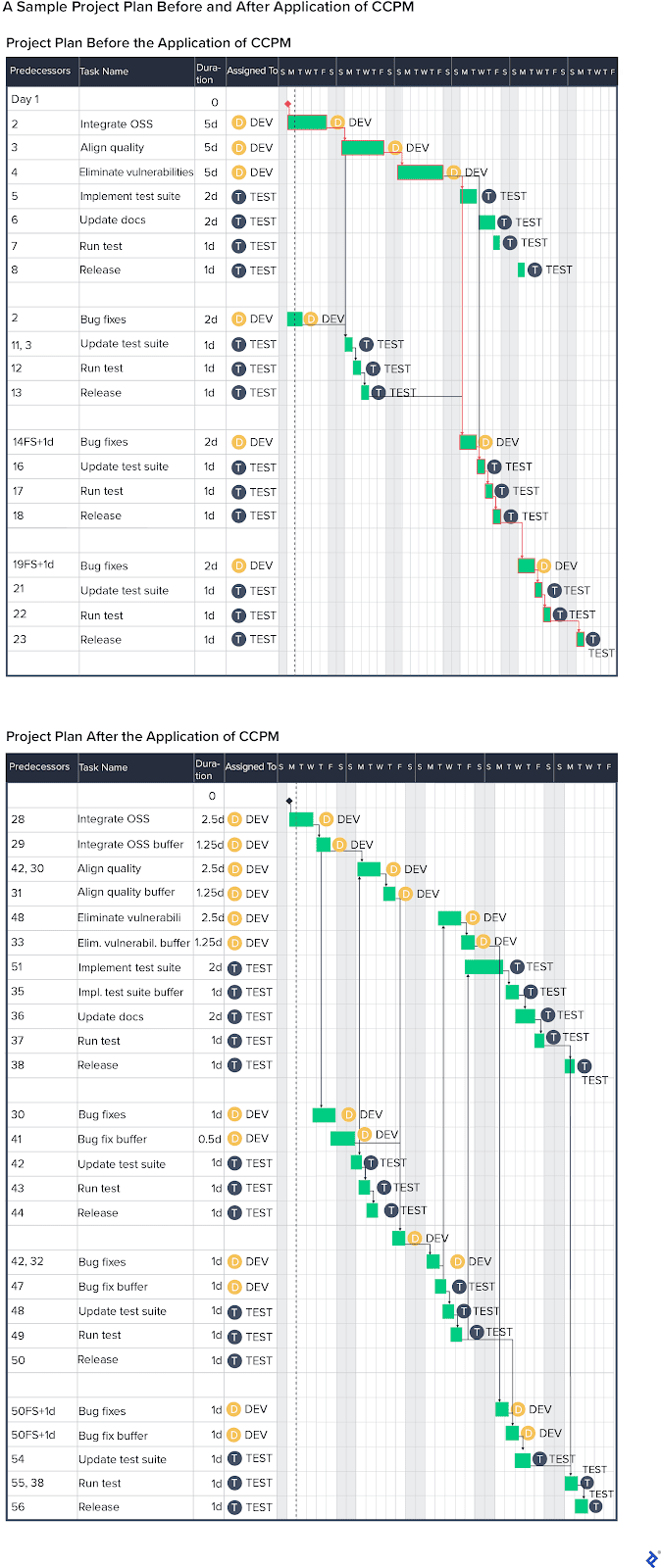

As soon as the stairs had been finished and the brand new plan is written, the variation will have to be visual. As proven within the pattern Gantt chart beneath, duties are assigned much less time around the board, however buffer and protection margins had been implemented to probably the most essential duties.

Two sections of a Gantt chart show a sample project plan before and after the application of critical chain project management.

Merging Lanes: Agile and CCPM

CCPM will also be thought to be an optimization of the Waterfall method, so making use of it to Agile won’t appear instantly intuitive. However each CCPM and Agile have the similar objective: to make sure venture potency through bettering pace and reliability. CCPM makes its adjustments at the entrance finish thru timeline making plans, while Agile makes its enhancements all through the paintings procedure after each dash. What this implies is that it’s now not tough to check a hybrid framework wherein paintings estimates are completed in CCPM, and the paintings itself is achieved in Agile.

Recall to mind it like a small venture that many of us do more than one occasions per week: riding to paintings. On this situation, you get started with a plan and time estimation in thoughts. There are sources (gasoline) and constraints (site visitors). There also are vital steps that need to be accounted for if the go back and forth goes to achieve success, like discovering parking. You most likely construct buffers into the plan for constraints you understand about forward of time, like leaving quarter-hour early in case of specifically dangerous rush hour site visitors. (This a part of the “pressure to paintings” venture seems to be so much like CCPM making plans.)

Whenever you’re in fact at the street, there are vital milestones that decide your resulting alternatives. Possibly you listen about an coincidence at the freeway, so that you to find some other on-ramp. Possibly a colleague calls and asks for a experience, so you permit the freeway for some time and go back again to it earlier than exceeding your time buffer. That is the Agile a part of the method. Sudden occasions (i.e., requirement permutations) result in some other trail, however you will have to take the time to stay as shut as conceivable to the unique plan.

There are a number of proposals for a way Agile will also be blended with CCPM, however for our functions we’ll read about a use case wherein CCPM is used to devise a venture, and Scrum is used to execute it.

CCPM and Agile: A Hybrid Use Case

An organization develops a product that has already penetrated a regulated marketplace. Rules require that this product meet prime requirements for reliability (in response to code high quality), safety certification, and license compliance. The corporate has determined to support product efficiency through integrating a brand new open-source tool (OSS) library with a database control device (DBMS).

The control staff estimates that the brand new DBMS will support key metrics like shopper retention price, internet promoter rating, and first-time acceptance fee; with the brand new DBMS, the corporate may outperform the contest, achieve its deliberate income objectives, and protected the following spherical of investment through the tip of the yr. Building is given 4 months to finish integration and check product alignment. This integration will wish to happen along the staff’s common upkeep obligations.

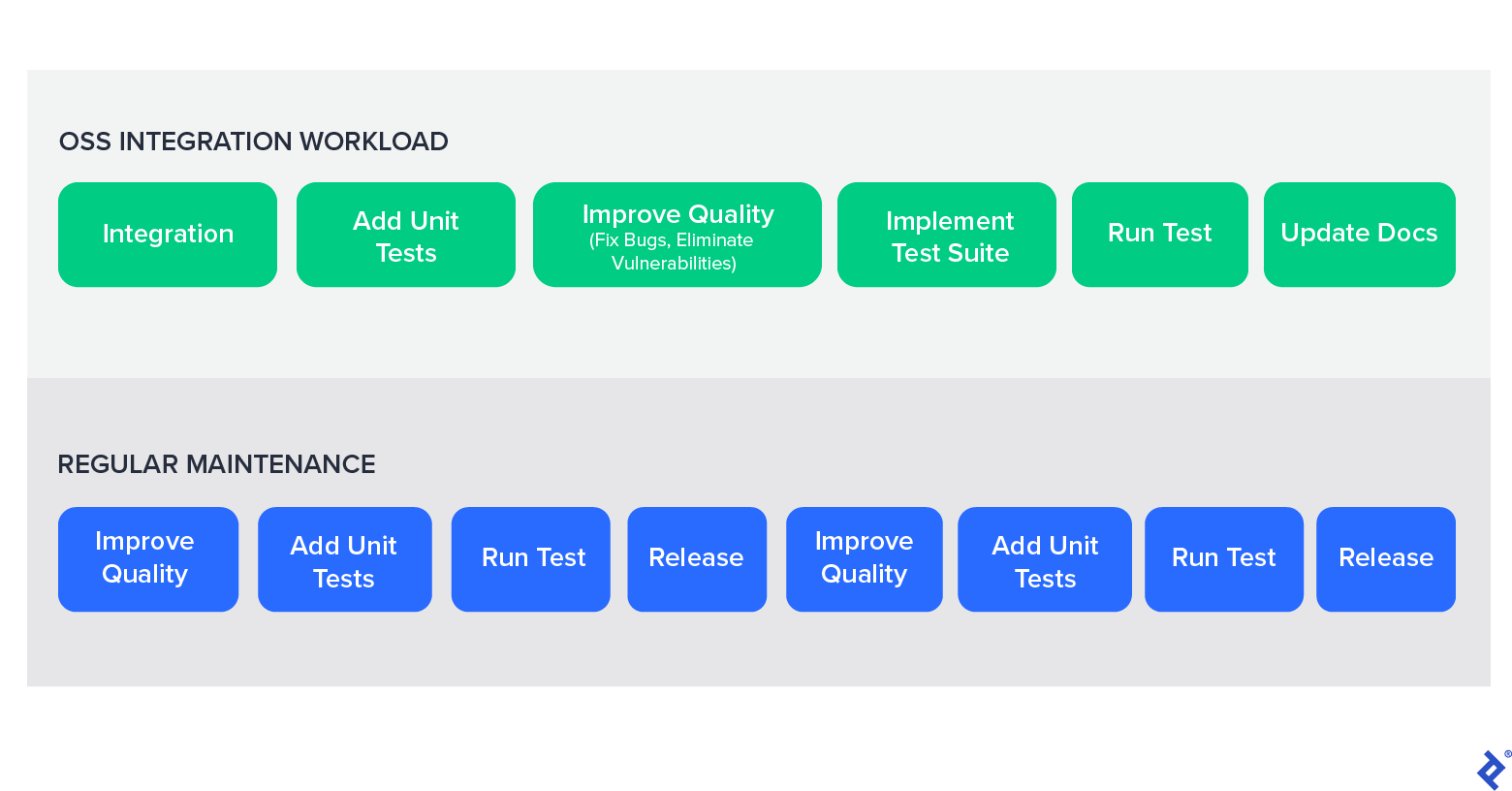

A row listing the stages of an OSS integration workload followed by a row listing the stages of regular maintenance.

The Downside

The improvement staff has inferred that the code high quality of the OSS library isn’t enough for a extremely regulated marketplace. The preliminary integration steps have exposed a number of defects and vulnerabilities, like hardcoded tokens and code duplication. This considerably will increase the total product’s technical debt. Because of the product’s massive buyer base, the advance and take a look at departments are already suffering to stay alongside of incoming give a boost to requests.

The incoming requests for computer virus fixes and backbone of vulnerabilities build up considerably. Toughen tickets are filed in a well timed approach, however the building staff doesn’t have the capability to maintain the additional requests or ok revel in with the newly built-in DBMS. The extra problem has additional taxed an already overburdened staff.

The trying out staff is suffering to put into effect a take a look at suite that adequately covers the newly built-in tool, and the discharge staff lacks the capability to replace documentation and the product’s internet presentation. The improvement staff lacks the supply to scrupulously take on the newly came upon problems, resulting in both patch paintings or delays, neither of which is a superb resolution. Each injury the unique plan.

The trying out staff additionally experiences an increasing number of problems in each dash. Its backlog is getting larger and the combination’s of entirety time is getting driven again. Industry power leads the venture supervisor to micromanage the of entirety of each and every assignment at the scheduled date, irritating everyone. Groups start to isolate themselves, the use of backfiring as a final hotel, which makes the whole lot worse.

The Answer

The improvement staff now faces a state of affairs wherein they should entire a big discrete venture, but additionally cope with new incoming requests and conform to exterior laws; it’s now not reasonable for them to rely only on Agile or Waterfall on this context. Since the staff already makes use of Scrum for brand new function building, and a hybrid Kanban framework for computer virus fixes and shopper customization requests, they’re reluctant to switch both method. However, driven through industry stakeholders to align the venture with their objectives (and pressing fundraising wishes), the staff makes a decision so as to add CCPM making plans to their workflow the use of the next 4 steps:

1. Determine the Crucial Chain

The venture supervisor determines a vital trail consisting of 8 duties:

  • Combine OSS
  • Align OSS high quality (refactor to handle defects and vulnerabilities)
  • Do away with vulnerabilities
  • Put into effect take a look at suite
  • Replace documentation
  • Run exams
  • Liberate
  • Repair insects (together with buyer give a boost to)

2. Determine Conceivable Useful resource Constraints

The limitations are transparent: The improvement staff lacks the desired bandwidth for the duties required; the code’s loss of adulthood provides complexity; and excessive multitasking is slicing into the builders’ availability. All staff participants will likely be to be had in the course of the venture, however there is not any price range to rent someone new.

The venture supervisor conducts an preliminary workload estimation to decide the tasks of the advance staff. The staff had in the past estimated the hassle that may pass into database integration, however since the high quality issues weren’t visual till integration had begun, the estimation didn’t account for the added effort of refactoring the database’s code.

There are a selection of how the workload will also be estimated. For example, the hassle had to align the OSS high quality may well be assessed the use of a mixture of tool composition research gear, code evaluation gear, and safety gear corresponding to Mend, SonarQube, Snyk, Coverity Scan, c2m, or Checkmarx. The staff may additionally run a technical debt evaluate suite like c2m or CloudZero, or use a supply code evaluate suite. However the true manner is much less necessary for our functions than the consequences:

Process

Days of Effort according to Dash

Combine OSS

5

Align OSS high quality

5

Do away with vulnerabilities

5

Put into effect take a look at suite

2

Replace documentation

2

Run exams

1

Liberate

1

Repair insects

2

3. Do away with Multitasking, Estimate New Time Body, Upload Buffers

Even if those duties are conceptually separate, in follow a venture supervisor will most likely carry out them multi functional sitting. Running below CCPM’s assumption that the removal of multitasking reduces vital time through part, the venture supervisor writes a brand new workload estimate. In addition they assign buffers (generally set to 50% of assignment effort estimation) to those the most important duties, in case of sudden delays.

Process

Days of Effort according to Dash

Buffer

Combine OSS

2.5

1.25

Align OSS high quality

2.5

1.25

Do away with vulnerabilities

2.5

1.25

Put into effect take a look at suite

2

1

Write documentation

1

0.5

Run exams

1

0.5

Liberate

1

0.5

Repair insects

1

0.5

4. Rewrite the Plan

With the brand new workload estimates and buffers, the venture length stays about the similar however the power on bottlenecks within the vital chain is comfy, making it a lot more most likely that the plan’s objective will likely be completed.

At this level, the CCPM plan is entire, and new sprints will also be deliberate that mirror the CCPM plan’s priorities. The improvement paintings remains to be completed in Scrum, with two-week sprints that comprise each integration and upkeep duties. However inside those sprints, the objectives of the CCPM plan tell dash making plans. Effort occasions are taken from the CCPM estimates, and integration duties are given precedence, with upkeep duties addressed handiest when a dash’s integration duties are entire. When the staff’s sprints are deliberate with those CCPM-established priorities in thoughts, staff participants will have to be capable of reach the DBMS integration inside the allocated time.

Managing Sources to Be certain that Supply

Whether or not used as a standalone technique or along side Agile, CCPM is a good device for balancing the power between control and building groups, and serving to venture managers meet their objectives whilst now not overwhelming groups or overtaxing sources. When CCPM is blended with Agile’s talent to react in actual time to sudden tendencies and buyer comments, the result’s an impressive framework for handing over tasks on time and inside price range.
